Due to the delayed completion of Product Testing, the Release for Manufacture milestone was delayed by 5 workdays which thus delayed starting the Draft Product Manual activity. If the Print Product Manual activity is also delayed by 10 workdays, what is the delay to completing the Product Available milestone?
Determine the correct formula and date for the late start for Activity 9001.
Constructability is NOT intended to:

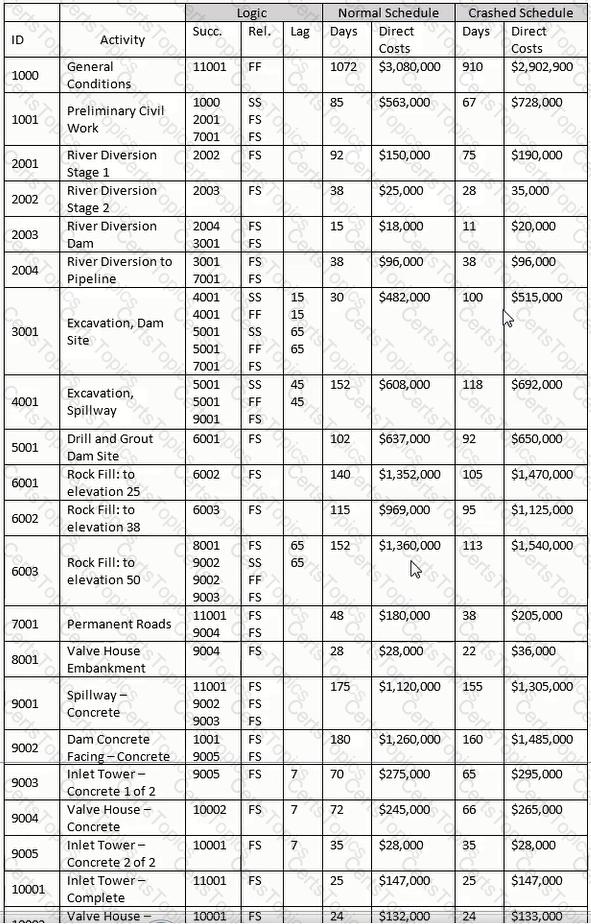

Using the crashed schedule, if you start Activity 2002 on 12 August 2021. what is the finish date for Activity 2002?
